Reabastecimiento de subcontratación¶
En la subcontratación de reabastecimiento, una empresa suministra los componentes de su producto a un subcontratista, que fabrica el producto y luego entrega el producto terminado al almacén de la empresa contratante.
Este artículo explica cómo configurar un producto subcontratado y recorrer el proceso de subcontratación de reabastecimiento.
Configuración¶
In order to use the resupply subcontractor workflow, users must follow the configuration process below:
Specify the subcontractor as a vendor on the subcontracted product.
Create a subcontracting-type BoM for the product and add the necessary components.
For each component, open its product form and set its Resupply Subcontractor on Order route.
Specifying the subcontractor as a vendor on the product form allows the contracting company to properly purchase the product from the subcontractor through a purchase order (PO). The bill of materials (BoM) allows the product to be manufactured externally by the subcontractor. The Resupply Subcontractor on Order route is applied to each component in order for them to be properly sent from the contractor to the subcontractor.
Specify product vendor¶
Para configurar el proveedor de un producto para el reabastecimiento de subcontratación, ve a y selecciona un producto o crea uno nuevo.
En el formulario del producto, haz clic en la pestaña Compra y añade el subcontratista del producto como proveedor haciendo clic en Añadir una línea. Selecciona el subcontratista en el menú desplegable Proveedor.
Luego, introduce el precio del producto en el campo Precio.
Finalmente, establece un tiempo de entrega para el producto en el campo Tiempo de entrega para especificar el número de días para que el subcontratista reciba los componentes, produzca el producto y entregue el bien terminado.
Nota
Dado que los contratistas no son responsables de fabricar el producto final, no es necesario configurar tiempos de entrega de fabricación en una BoM. En su lugar, proporciona solo un único Plazo de entrega en la tarifa del proveedor, teniendo en cuenta la duración para que el subcontratista reciba los componentes del contratista, fabrique el producto y entregue el producto terminado de vuelta al contratista.
Configure BoM¶
Después de especificar el proveedor, configura un BoM de tipo subcontratación para el producto. Para comenzar, haz clic en el botón inteligente Lista de materiales en la página del producto. Luego, selecciona el BoM deseado o crea uno nuevo.
Truco
Como alternativa, vaya a y seleccione la lista de materiales para el producto subcontratado.

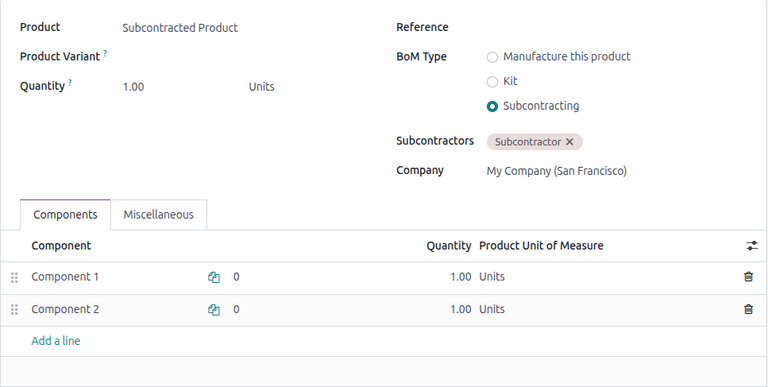

En el campo Tipo de LdM, selecciona la opción Subcontratación. Luego, añade uno o más subcontratistas en el campo Subcontratistas a continuación.
Finalmente, añade todos los componentes necesarios en la pestaña Componentes. Para añadir un nuevo componente, haz clic en Añadir una línea. Luego, selecciona el componente en el menú desplegable Componente y especifica la cantidad requerida en el campo Cantidad.
Configurar componentes¶
En la subcontratación de reabastecimiento, cada componente debe configurarse individualmente con la ruta Reabastecer subcontratista al realizar pedido. Esto permite que los componentes se transfieran del contratista al subcontratista cuando se realiza un PO para el producto subcontratado.
Para configurar la ruta de un componente, selecciona el nombre del componente en la pestaña Componentes y haz clic en la flecha (Enlace interno). Alternativamente, ve a y selecciona el componente.

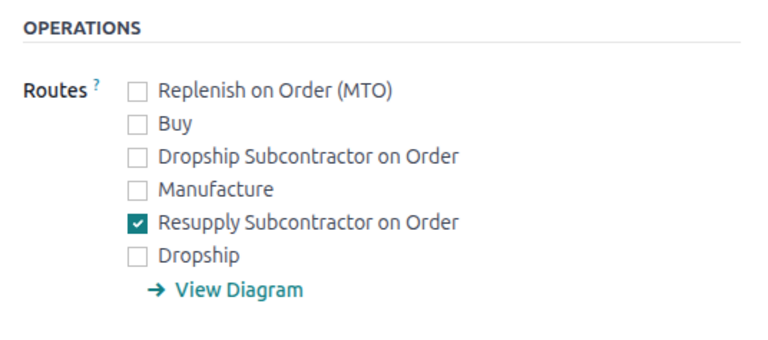

En el formulario del producto componente, haz clic en la pestaña Inventario. Luego, en la sección Rutas, selecciona la ruta Reabastecer subcontratista al realizar pedido.
Importante
Repita este proceso en todos los componentes que se deben enviar al subcontratista.
Flujo¶

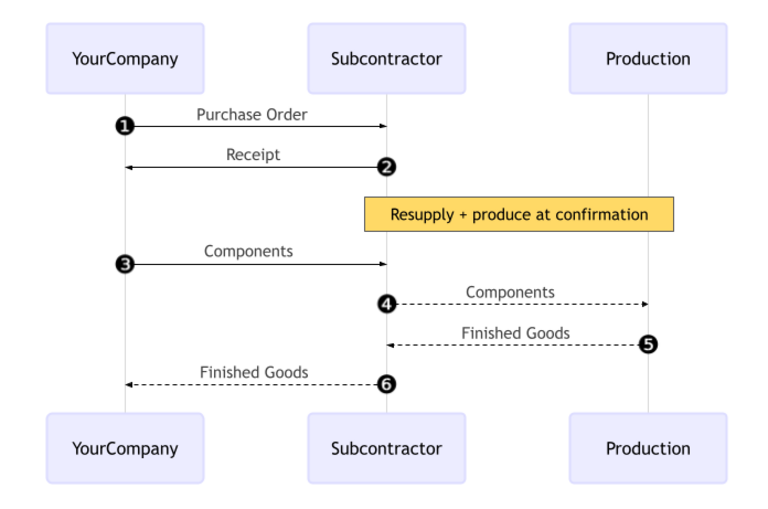

The resupply subcontracting workflow can be summarized in the following steps:
Validate the resupply order to send the components.
Validate the receipt to receive the final product.
The workflow begins by creating a PO to purchase the product from the subcontractor (1).
El contratista (TuEmpresa) confirma entonces el PO, lo que crea tanto un pedido de reabastecimiento para transferir los componentes como una recepción para recibir el producto final (2) del subcontratista.
Next, the contractor validates the transfer of components to the subcontractor (3). The subcontractor begins producing the product.
Once the product has been produced and received, the contractor validates the receipt (6) to trigger inventory moves from the subcontractor to the company’s stock (4, 5).
Create and confirm subcontractor PO¶
Para crear un PO para el producto subcontratado, ve a y haz clic en Nuevo.
Comienza a rellenar el PO seleccionando un subcontratista del menú desplegable Proveedor. En la pestaña Productos, haz clic en Añadir un producto para crear una nueva línea de producto. Selecciona el producto subcontratado en el campo Producto, e introduce la cantidad en el campo Cantidad.
Después de añadir el producto, el campo Llegada prevista se actualiza con la fecha de entrega esperada del producto terminado, como se configuró anteriormente con el Plazo de entrega del proveedor.
Finalmente, haz clic en Confirmar pedido para confirmar el PO. Se crean automáticamente una recepción y un pedido de reabastecimiento, accesibles a través de los botones inteligentes Recepción y Reabastecimiento en la parte superior del formulario.
Validar orden de reabastecimiento¶
Haz clic en el botón inteligente Reabastecimiento en la parte superior del PO para abrir el pedido de reabastecimiento y haz clic en Validar para confirmar que los componentes se han enviado al subcontratista.
Alternativamente, ve a la aplicación , haz clic en el botón (#) Por procesar en la tarjeta Reabastecer subcontratista y selecciona el pedido de reabastecimiento correspondiente. Luego, haz clic en Validar para confirmar que los componentes se han enviado al subcontratista.
Procesar una recepción¶
Después de confirmar el pedido de reabastecimiento, el subcontratista fabrica el producto y entrega el producto terminado de vuelta a la empresa contratante.
Para recibir el producto terminado del subcontratista, haz clic en el botón Recibir productos en el PO, o haz clic en el botón inteligente Recepción en la parte superior de la página. Luego, haz clic en Validar para introducir el envío entrante en el inventario.
Nota
Si los flujos de inventario de varios pasos están habilitados, deben validarse transferencias adicionales para introducir el producto entrante en el stock.
Rastrear movimientos de inventario¶

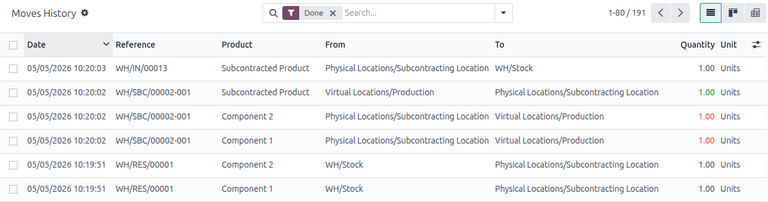

Después de validar la recepción, Odoo genera automáticamente movimientos de inventario para rastrear el movimiento de productos subcontratados entre ubicaciones. Para ver estos movimientos de inventario, ve a .
En la subcontratación de reabastecimiento, Odoo primero transfiere cualquier componente del producto a una Ubicación de subcontratación dedicada. Una ubicación virtual llamada Producción consume los componentes y produce el producto terminado. Una vez producido, el producto regresa a la Ubicación de subcontratación antes de ingresar finalmente al stock del contratista cuando se valida la recepción.
